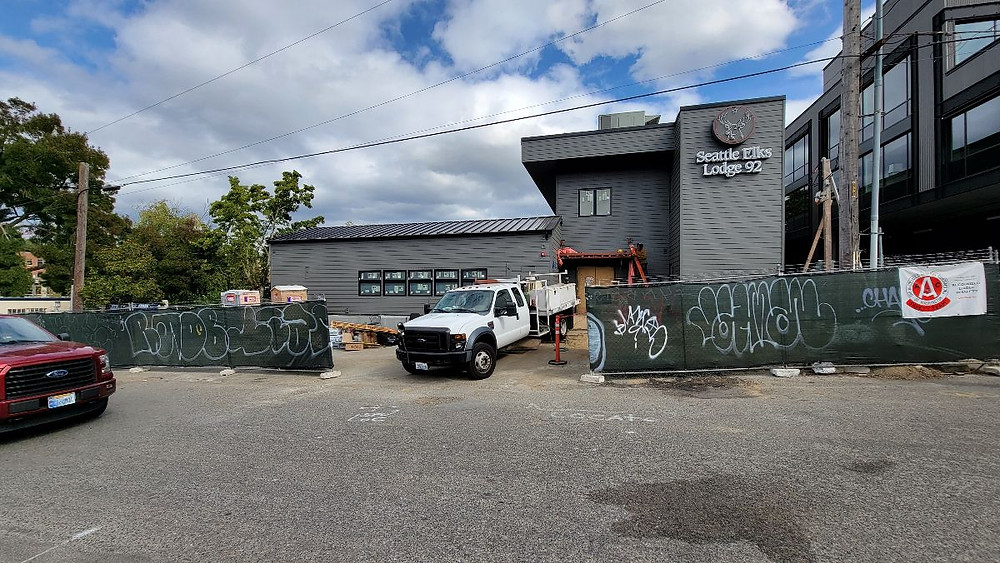

Lodge Building Update



Construction update - 09/03/21 We currently on schedule with the project and there have been no major problems. We are on track to reach substantial completion by the end of the second week of October! The last remaining major item involves permitting for repaving the North and East patios. We anticipate that we will receive this permit and begin the repaving effort within the next two weeks.



Other notable events are set forth below:

  • Bar tops for first floor bar will be templated next week

  • Bargreen kitchen and bar equipment installation is underway

  • Interior lighting has been installed

  • Exterior signage installation has been completed

  • Standing seam roof work is ongoing and is expected to be completed by 9/07/21

  • Tile and grout work is completed except for main entrance stairway

  • Siding punch list is 90% and should be complete by 9/07/21

  • US Mechanical is completing the kitchen duct and grease exhaust fan work

  • Exterior painting resumes 9/07/21

  • Remaining door and interior trim work resumes 9/07/21

  • Interior plumbing will begin week of 9/06/21

  • Fireplace and trim work to be installed the week of 9/07/21

Respectfully submitted,

Your Seattle Elks No. 92 Board of Directors
